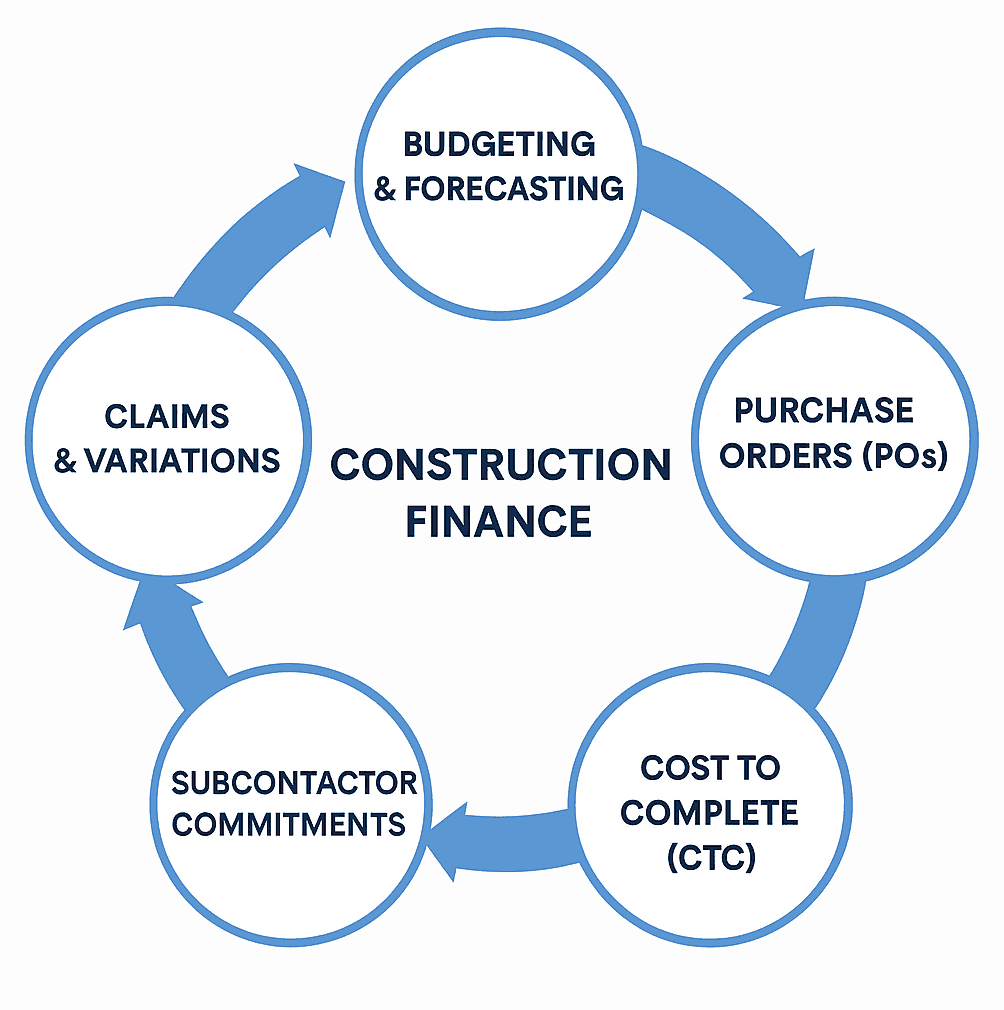

construction lifecycle

Financial Management

Construction Finance & Contracts Admin Guide

Master key areas of construction finance: budgeting, forecasting, purchase orders, subcontractor commitments, claims management, and variations. Learn how to keep projects on track, within budget, and financially sound by effectively managing financial processes throughout the lifecycle.

The Construction Finance Lifecycle: A Beginner’s Guide

Welcome to the world of construction finance! As a cadet Contract Admin, you’re stepping into an exciting and dynamic field that plays a critical role in ensuring that construction projects are completed on time, within budget, and in compliance with financial regulations. Understanding the financial aspects of construction is key to successfully navigating the complexities of the industry.

What is Construction Finance?

Construction finance is the process of managing the financial resources of a construction project. This involves overseeing costs, ensuring that budgets are adhered to, managing cash flow, and dealing with financial transactions related to contractors, suppliers, subcontractors, and clients. A construction project, whether it's a new building, road, or infrastructure project, requires meticulous planning and financial oversight at every stage—from initial budgeting to project completion.

Why is Construction Finance Important?

Without effective financial management, even the most well-planned construction projects can run into significant problems, such as cost overruns, delays, or disputes. Proper construction finance management helps keep projects within their financial scope, ensures smooth cash flow, and minimizes financial risks. It’s all about maintaining financial control while delivering quality work on time.

Key Areas of Construction Finance

Here’s a breakdown of the key elements you’ll encounter in construction finance:

  1. Budgeting and Forecasting: Before the first brick is laid, detailed budgeting and forecasting are necessary. This involves estimating the overall project costs, identifying potential financial risks, and developing strategies to stay on track.

  2. Purchase Orders (POs): Purchase orders are formal requests for materials or services required for the project. Managing POs efficiently ensures that materials are purchased at the right time and at the right price, preventing supply chain disruptions.

  3. Subcontractor Commitments: Construction projects often rely on subcontractors for specialized work. Managing contracts, commitments, and payments to subcontractors is a crucial aspect of construction finance to ensure timely delivery and maintain good working relationships.

  4. Claims and Supplier Invoices: Throughout the project, various claims may arise—whether from subcontractors, suppliers, or for retention funds. Managing these claims and invoices ensures that payments are made accurately and on time, and any issues are promptly resolved.

  5. Variations: Variations refer to changes in the original scope of work, which often lead to increased costs or project delays. Managing variations properly is key to keeping the project financially on track.

  6. Head Contract Management: The head contract is the main agreement between the contractor and the client. Managing this contract, including variations and claims, is crucial for financial transparency and ensuring the project meets the client's expectations.

  7. Cost to Complete (CTC): The CTC represents the estimated cost of completing the project based on the work remaining. It’s a critical tool used for assessing whether the project is on budget and forecasting any additional financial needs as the project nears completion.

What Will You Learn as a Contract Administrator (CA)?

As a cadet in construction finance, you will learn how to:

  • Prepare budgets and forecasts for construction projects.

  • Track costs and manage cash flow throughout the project lifecycle.

  • Handle purchase orders, subcontractor payments, and supplier invoices.

  • Manage variations and claims from subcontractors and clients.

  • Calculate and report the cost to complete (CTC) and understand its importance in financial decision-making.

Construction finance is a highly specialized field that requires attention to detail, strong analytical skills, and an understanding of the overall construction process. As you gain more experience and knowledge, you will become a key player on your given construction project in ensuring the financial success of your projects.

1. Budgeting and Forecasting

Budgeting is the first step in the construction finance lifecycle. A well-prepared budget sets the foundation for how the financial aspects of the project will be managed.

Key Elements in Budgeting:

  • Preliminary Budget: Estimated costs based on conceptual design.

  • Detailed Budget: Costs after more precise design and scope definition.

  • Forecasting: Adjusting the budget as the project progresses to ensure it remains accurate.

Category

Initial Estimate

Revised Estimate

Variance

Labor Costs

$500,000

$550,000

+$50,000

Material Costs

$300,000

$280,000

-$20,000

Equipment Costs

$150,000

$150,000

$0

Subcontractor Costs

$200,000

$210,000

+$10,000

Total Project Cost

$1,150,000

$1,190,000

+$40,000

2. Purchase Orders (POs)

A purchase order (PO) is a formal request to suppliers or subcontractors to provide materials or services. Managing POs efficiently is crucial to ensuring that the project stays within budget.

PO Management Steps:

  1. Create Purchase Order: Based on the needs and budget.

  2. Send PO to Supplier/Subcontractor: The supplier acknowledges the order.

  3. Track PO Status: Monitor delivery timelines and costs.

  4. Close PO: Once the goods/services are delivered and paid for.

PO Number

Supplier

Amount

Status

Delivery Date

PO12345

Supplier A

$50,000

Completed

2025-04-20

PO12346

Supplier B

$30,000

In Progress

2025-05-05

3. Subcontractor Commitments (Major & Minor)

Subcontractor commitments involve agreements to hire subcontractors for specific work packages. These commitments are vital for cash flow management and need to be tracked closely.

Types of Subcontract Commitments:

  • Major Commitments: Significant portions of work (e.g., structural, electrical).

  • Minor Commitments: Smaller, less critical tasks (e.g., cleaning, painting).

Subcontractor

Scope of Work

Commitment Amount

Payment Terms

Due Date

ABC Constructions

Concrete Work

$300,000

30 Days

2025-05-15

XYZ Electrical

Electrical Install

$150,000

45 Days

2025-06-01

4. Claims, Supplier Invoices, Retention Claims, and Credits

Managing claims, invoices, retention claims, and credits is critical in construction finance. It ensures that contractors and suppliers are paid correctly, and project finances remain stable.

Types of Claims:

  • Supplier Invoices: Bills for materials or services provided.

  • Retention Claims: A portion of the contract amount withheld until project completion to ensure performance.

  • Credits: Deductions due to errors or disputes (e.g., defective materials).

Claim Type

Amount

Date Received

Status

Due Date

Supplier Invoice

$25,000

2025-04-18

Approved

2025-05-05

Retention Claim

$20,000

2025-04-20

Pending

2025-12-01

Credit Adjustment

-$5,000

2025-04-22

Approved

2025-05-01

5. Variations

Variations refer to changes in the original scope of work. These changes can arise from design modifications, unforeseen conditions, or client requests. Properly managing variations is crucial for maintaining project profitability.

Variation Process:

  1. Variation Request: Initiated by the client or contractor.

  2. Assessment & Pricing: Evaluation of the impact on cost and time.

  3. Approval: The variation is reviewed and approved.

  4. Implementation: Work is carried out based on the variation.

Variation Number

Description

Original Cost

New Cost

Approved

V12345

Design Change

$20,000

$25,000

Yes

V12346

Additional Works

$10,000

$12,000

No

6. Head Contract Claims, Commitments, and Variations

Head contracts govern the overall terms between the contractor and the client. Managing claims, commitments, and variations at this level ensures the project’s financial integrity.

Head Contract Process:

  1. Contract Signing: Final agreement between contractor and client.

  2. Contract Administration: Ongoing management of claims and variations.

  3. Final Claims & Close-out: Submission of final claims and project close-out.

Contract Item

Amount

Paid to Date

Outstanding

Status

Original Contract

$1,000,000

$600,000

$400,000

Active

Variation 1

$25,000

$10,000

$15,000

Approved

Variation 2 (Change)

$50,000

$30,000

$20,000

Pending

7. Cost to Complete (CTC)

CTC is an estimate of the remaining costs needed to complete the project. It includes all labor, material, equipment, and subcontractor costs, and provides a clear picture of financial projections.

CTC Calculation Formula:

CTC=Total Estimated Cost−Cost Incurred to Date\text{CTC} = \text{Total Estimated Cost} - \text{Cost Incurred to Date}CTC=Total Estimated Cost−Cost Incurred to Date

CTC Example Table:

Cost Category

Estimated Cost

Cost Incurred

Remaining CTC

Labor

$500,000

$250,000

$250,000

Materials

$300,000

$100,000

$200,000

Equipment

$150,000

$75,000

$75,000

Subcontractors

$200,000

$120,000

$80,000

Total CTC

$1,150,000

$545,000

$605,000

Software Solutions for Managing Construction Finance & Contracts Administration

Relying on manual methods for finance and contracts management is both inefficient and prone to errors. A comprehensive software solution can help streamline and automate the various processes involved, from initial budgeting through to final project completion. Below are some of the most reliable software solutions designed to cover the entire construction finance lifecycle.

8. Plexa Construction Management Software

Plexa is an all-in-one construction management platform that offers robust features for project finance and contracts administration. It enables seamless tracking of budgets, cost forecasting, purchase orders, and subcontractor management.

  • Key Features:

    • Budgeting & Forecasting: Tracks project budgets in real-time and forecasts potential costs.

    • Purchase Orders (POs): Manages and tracks purchase orders, ensuring accurate and timely procurement of materials.

    • Subcontractor Management: Facilitates contract creation, payments, and performance tracking.

    • Claims Management: Manages change orders, claims, and variations efficiently.

    • Cost-to-Complete (CTC): Monitors the remaining budget and projects the costs to complete the project.

  • Benefits:

    • Centralized platform for managing all aspects of construction finance.

    • Real-time reporting and notifications.

    • Integration with other software, ensuring smooth workflow.

Your Construction Finance Adventure Will be Dynamic!

Whether it’s managing budgets, navigating subcontractor commitments, or tracking variations like a pro, you're now equipped to handle the financial side of construction with confidence. As you move forward, remember: every project is a new challenge, but with the right financial tools in hand, you’ve got the power to turn even the toughest construction puzzles into perfectly executed plans.

Get ready to dive into the dynamic, fast-paced world of construction finance—where every day brings new opportunities to learn, grow, and make a real impact. Welcome to the adventure, and we’re excited to see you build your financial expertise one project at a time!
